Event RACI template Who owns it? Check the column

Template

Event Ownership Matrix

A phase-by-phase matrix that assigns one Accountable owner to every event task, from the first planning meeting to the week after the event. Role columns cover the sponsor through the booth captain, with a dashboard that tracks load and status.

  • 61 sample tasks across 5 phases and 11 workstreams
  • One Accountable owner and a clear Responsible role on every row
  • T-minus due dates that update from a single event-date cell
  • A dashboard sheet showing A-load per role and status counts
  • A flat CSV version for other project tools

Download Excel, 19 KBDownload CSV, 15 KB

Free. No email needed. Opens in Excel.

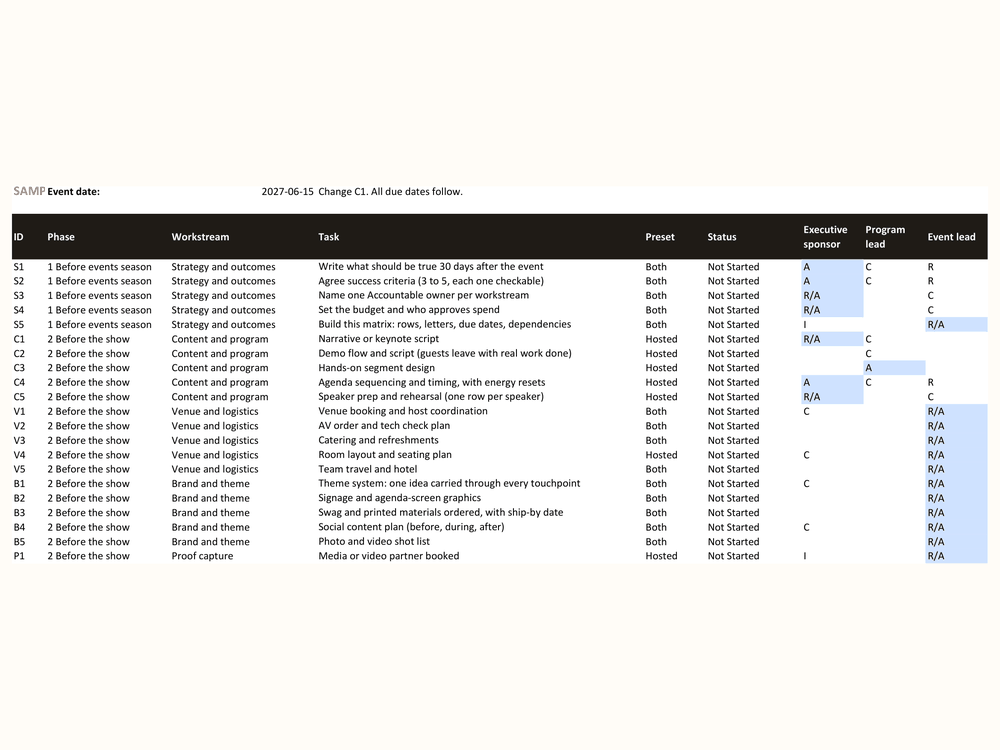

The Event Ownership Matrix spreadsheet, showing sample tasks with phase, workstream, status and role columns including Accountable and Responsible assignments.
Sample event, June 2027

Know who owns every task on your event, and see who is carrying too much before it bites.

The Event Ownership Matrix is an Excel workbook that lays out your event phase by phase, from the first planning meeting to the week after. Every task gets one Accountable owner and a clear Responsible role. Type the event date into one cell and every due date moves with it. A dashboard shows how many tasks each role answers for, with a status count for the whole plan.

We built it with sample tasks already in place. Swap in your own tasks, write down who fills each role, and set your date. Then open the dashboard before each planning meeting, so “who’s on it?” is answered before anyone asks.

What are event planning roles and responsibilities?

Event roles are defined by what each person owns, not by their job title.

Search for this phrase and you’ll mostly find job descriptions for event planners. Useful if you’re hiring. Not much help if you’re three weeks into planning a customer day and nobody can say who booked the photographer. Marketing, operations, sales and the executive who asked for the event all touch it, and a title tells you nothing about who confirms the caterer.

Let’s say your company is hosting a partner day. Marketing assumes operations handled the venue contract, because operations handles contracts. Operations assumes marketing handled it, because marketing picked the venue. Both are reasonable. Both are wrong. And nobody finds out until the venue asks for a signature that should have come in last month.

A RACI is the simplest way I know to write ownership down. It’s a grid: tasks down the side, roles across the top, and a letter in each cell that says how that role touches that task. Events Authority didn’t invent RACI; it’s a general project grid used well beyond events. The event part is how you apply it: phases, workstreams and due dates tied to one event date.

If the honest answer is that nobody on your team has room to own the plan at all, that’s a different problem, and Events Authority offers help owning the whole corporate event plan. If your team can own it, the matrix above gives them the columns.

What do R, A, C and I mean on an event?

Letter What it means On an event The common mistake
R, Responsible Does the work The event lead confirms the room layout with the venue; the designer builds the signage Piling doers onto one row until nobody can tell whose part is late. If each speaker preps separately, give each speaker a row.
A, Accountable Owns the outcome and decides when the task is done The executive sponsor owns the agenda; the event lead owns the venue Two A’s on a task, or none. Either way, nobody chases it.
C, Consulted Asked before the task is finished; a two-way conversation The product lead is consulted on the demo timing; the host venue is consulted on the room Consulting everyone, so every decision waits for a round of opinions.
I, Informed Told once it’s done; a one-way update Sales is told when the invitations go out Copying everyone on everything, or forgetting the one role that needed to know.

Two rules sit on top of the table.

First, Responsible and Accountable can be the same role. On a small task, the role that does the work can also sign it off, and splitting them just adds a handoff. Split them when the task is big enough that someone should check the work before it’s called done.

Second, a blank cell is an answer. It means “not involved,” and a well-built matrix has plenty of them. A matrix with a letter in every cell looks thorough. Look closer and nobody decided anything.

How do you fill in an event RACI template?

This assumes you already know what the event has to achieve and roughly what it has to include. If you don’t, start with the full corporate event planning process and come back when you have a plan to assign.

The sample file comes filled in with 61 sample tasks across five phases and 11 workstreams, so you’re editing from the first minute. Work through it in this order.

  1. List your workstreams. A workstream is a lane of related work: the venue, guest communications, the program, the room on the day. Keep the sample’s lanes that fit your event and delete the ones that don’t. Deleting a workstream is a decision; leaving a dead one in just hides the real gaps.
  2. List the tasks in each workstream. One task per row, written so someone could tell when it’s done. “Venue” is a topic. “Venue contract signed” is a task. For task ideas, the event management checklist runs phase by phase.
  3. Give every task exactly one A. Go row by row and ask: if this task isn’t done on time, whose phone rings? That role gets the A. If the room argues for two names, the task is probably two tasks. Split it.
  4. Mark the R. Who actually does the work? On small tasks it’s often the same role as the A, and that’s fine. On bigger ones, name the doer separately, so the Accountable owner is checking the work instead of doing it.
  5. Add C and I only where they change something. Consult a role when their input could change the result. Inform a role when they’ll act on the news. If you can’t say what a C or an I will do with it, leave the cell blank.
  6. Write down who fills each role. The columns are roles, from the sponsor through to the booth captain, not names. Put a name against each role somewhere the whole team can see, so when someone changes jobs mid-plan you update one line and every row stays as it is.
  7. Set the event date. Type it into the event-date cell and every T-minus due date updates from it. T-minus means counted backward from the event date: a task due four weeks before the event stays four weeks before, wherever the date lands. If the dates now fall in the past, you have a scope problem, not a spreadsheet problem. Cut tasks or move the event.
  8. Read the dashboard. It shows the A-load per role, meaning how many tasks each role is Accountable for, and a count of tasks by status. Look for the role carrying far more A’s than anyone else. If it’s the event lead, some of that is the job. Too much of it means that when their week goes sideways, much of the plan goes with it. Move A’s to other roles now, while there’s still time to talk it through.
  9. Use statuses as gates. A status should mean the same thing to everyone. The line that matters most is between finished and signed off: the Responsible finishes the work, and the Accountable decides it’s done. Agree on that before the first status meeting.
  10. Set a freeze date. Pick a date a few days before the event. After it, nothing new gets planned, and every task is either complete or waiting for its Accountable to sign it off. Rehearsal is for running the show, not finishing it.

Before you share the file, filter the Accountable column. No row should be empty and none should carry two A’s. Then confirm every row has an R, and that the dashboard doesn’t show one role answering for most of the event.

What goes wrong when event ownership isn’t written down?

Nothing, for a while. That’s the trouble. Four patterns show up when ownership lives in people’s heads instead of in a column.

Two owners. It can start as a kindness: two roles share a task so neither carries it alone. On the grid it shows up as two A’s on one row, and it’s easy to read that as teamwork instead of a warning.

No owner. The task made it onto the list, which felt like progress. Nobody’s name made it onto the task. It sits there looking handled until the week of the event, when it becomes the thing everyone hears about.

The Accountable who is also everyone’s Consulted. One role, say the event lead, gets consulted on every decision in every workstream. The matrix looks tidy. In practice every decision queues at the same desk. The dashboard counts A’s; count that role’s C’s too, by filtering its column, and hand some of those decisions to the roles doing the work.

The task nobody Informed. The guest list changed, the sponsor approved the new agenda, the room moved to the second floor. The work was done. The role that needed to know, say the person running check-in, never heard. Informed is the smallest letter on the grid, and when it’s missing, the guests can be the ones who notice.

Bottom line: when two people own a task, each one is standing in the wings waiting for the other to walk on. The cue comes, the stage stays empty, and both of them have a perfectly good reason why.

So when you find two A’s on a row, don’t split the difference and don’t wait to see who steps up. Pick one name, move the other to Consulted, and tell them both today.

Common questions

What does RACI stand for? Responsible, Accountable, Consulted and Informed. Responsible does the work. Accountable owns the result and says when it’s done. Consulted is asked for input while the work is under way. Informed hears about it afterward.

Can the same person be both Responsible and Accountable? Yes. On a small task, the role that does the work can also sign it off, and that’s the simplest setup. Split the two when the task is big enough that someone should check the work before it’s called done.

How many Accountable people can a task have? One. Several roles can be Responsible for a task, but exactly one is Accountable. If two people both feel accountable, pick one and make the other Consulted. If nobody is, the task has no owner yet.

What is the difference between a RACI and a task list? A task list says what has to happen and when. A RACI adds ownership to each row: which role does the work, which one owns the result, and who needs to be asked or kept up to date. Start from a task list, then use the matrix to put a role on every row.

Does the template work in Google Sheets? The workbook is built and tested for Excel. Google Sheets and other spreadsheet apps haven’t been tested, so if you open it elsewhere, check that the due dates and the dashboard still update before you rely on them. The download also includes a flat CSV version for teams that track work in another project tool.

Before the curtain goes up

One A on every row, and a name behind every role. Then the room can run the show.

If you’d like an outside read on who owns what before the event, request a complimentary event assessment.

Send over next year’s calendar and the packages you are looking at. You get a written read on which shows are worth the money and what is leaking on the way out.

Get your event assessment

COMPLIMENTARY · ONE CONVERSATION · NO DECK
